LAKEVIEW 2025

This full reconstruction—from underground infrastructure to a new road surface—represents a major investment in our town’s future.

PUBLIC PRESENTATION OF THE LAKEVIEW PROJECT

Watch the video
Consult the presentation

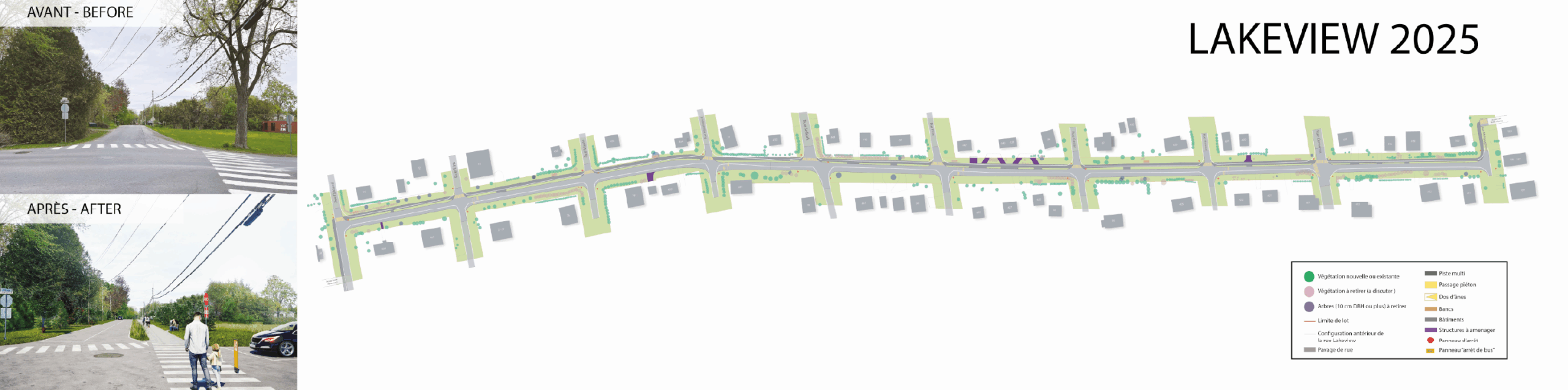

Consult the project plan

Work and closures planned: weeks of October 13 and 20, 2025

We are pleased to announce that the foundation and excavation work, along with the installation of drainage infrastructure and retention basins along Lakeview, is now complete. This marks an important milestone in the project and brings us one step closer to its completion.

In the coming two weeks, grading, leveling, and possibly paving will be carried out on Lakeview, from Selkirk to Oakland. Work on landscaping and paving the multi-purpose path between McNaughten and Selkirk is continuing. Please be aware that all work is subject to weather conditions.

Selkirk to McNaughten
Paving and landscaping operations continue.

Selkirk to Oakland
Grading and levelling in preparation for paving.

Street and intersection closures
Expect temporary restrictions, especially during paving operations.

Work and closures planned: week of October 6, 2025

The work planned includes: removing asphalt at the Oakland/Lakeview intersection, foundation work between Selkirk and Oakland, and paving along both the multi-purpose path and Lakeview. Crews will also be planting trees and shrubs within the Town right-of-way. Please note that a second layer of asphalt will be applied on Lakeview next spring, after the freeze-thaw cycle.

Selkirk to McNaughten
Paving operations continue.

Selkirk to Oakland
• Excavation and foundation work continue from Maple to Oakland.
• One (1) water service connection will be done on Monday morning. Anticipate cloudy or brownish water in the area from Selkirk to Oakland.

Street closures
The following section of Lakeview will be closed:
• Elm to Oakland

Intersection closures
The following intersections may be fully or partially closed. Please respect the signage in place:
• Elm and Lakeview; and
• Oakland and Lakeview.

Work and closures planned: week of September 29, 2025

Due to weather delays, paving of the multi-purpose path between Selkirk and McNaughten is now planned for the week of September 29. Excavation work will continue through to Oakland.

Selkirk to McNaughten
Paving of the multi-purpose path.

Selkirk to Oakland
• Excavation continues from Maple to Oakland.
• Storm sewer and water service connections will be done as the excavation advances. Anticipate cloudy or brownish water in the area from Selkirk to Oakland.

Street closures
The following section of Lakeview will be closed:
• Maple to Oakland;

Intersection closures
The following intersections may be fully or partially closed. Please respect the signage in place:
• Maple and Lakeview; and
• Elm and Lakeview.

Work and closures planned: week of September 22, 2025

The project continues to move rapidly, with work planned along the entirety of Lakeview, from McNaughten to Elm.

Selkirk to McNaughten
Final levelling and paving of the multi-purpose path.

Selkirk to Oakland
• Excavation continues from Hazelwood to Elm.
• Storm sewer and water service connections will be done as the excavation advances. Anticipate discoloured water in the area from Selkirk to Oakland.

Street closures
The following section of Lakeview will be closed:
• Hazelwood to Elm;

Intersection closures
The following intersections may be fully or partially closed. Please respect the signage in place:
• Hazelwood and Lakeview;
• Maple and Lakeview; and
• Elm and Lakeview.

Work and closures planned: week of September 15, 2025

The project will evolve rapidly over the next two weeks, with work planned along the entirety of Lakeview, from McNaughten to Oakland.

NOTICE: The intersection of Cameron and Lakeview will be completely closed at some point during the week of September 15th. Traffic will be detoured along adjacent streets.

Selkirk to McNaughten (including the intersection of Cameron)
Monday to Wednesday: grading and levelling
Thursday to Friday: paving operations will take place, barring any unforeseen delays or poor weather conditions. Expect delays of up to 45 minutes to enter or access your driveway. Access to this section of Lakeview will be restricted.

Selkirk to Oakland
Monday to Friday: Excavation continues from Maple to Oakland with the addition of a second excavation team.
• Storm sewer and water service connections will be done as the excavation advances. Anticipate discoloured water in the area from Selkirk to Oakland.

Street closures
The following sections along Lakeview will be closed:
• Selkirk to Hazelwood;
• Cameron to Melrose; and
• Cameron to McNaughten.

Intersection closures
The following intersections may be fully or partially closed. Please respect the signage in place:
• Selkirk and Lakeview;
• Hazelwood and Lakeview; and
• Cameron and Lakeview.

Discoloured water

  • During the water service connection work, residents may notice temporary discolouration in their water. This is caused by the disturbance of naturally occurring iron particles that settle at the bottom of the aqueduct system.
  • As water flow is redirected during the connection process, these particles can become stirred up, leading to a change in water appearance. Despite the discolouration, the water remains safe to drink.
  • If you experience discoloured water, run your cold water until it clears.
Work and closures planned: week of September 8, 2025

IMPORTANT NOTICE:

The intersection of Cameron and Lakeview will be partially closed the week of September 8th. Alternating traffic will be allowed; flag-persons will be on site to manage the traffic

Storm sewer and water service connection work

  • Lakeview, from Selkirk to Hazelwood – anticipate discoloured water (see below).
  • Intersection of Cameron and Lakeview.

Street closures

The following street sections on Lakeview will be closed:

  • Melrose to Cameron;
  • McNaughten to Cameron; and
  • Selkirk to Hazelwood.

Intersection closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Selkirk and Lakeview;
  • Hazelwood and Lakeview; and
  • Cameron and Lakeview.

Discoloured water

  • During the water service connection work, residents may notice temporary discolouration in their water. This is caused by the disturbance of naturally occurring iron particles that settle at the bottom of the aqueduct system.
  • As water flow is redirected during the connection process, these particles can become stirred up, leading to a change in water appearance. Despite the discolouration, the water remains safe to drink.
  • If you experience discoloured water, run your cold water until it clears.
Work and closures planned: week of September 2, 2025

IMPORTANT NOTICE:

The intersection of Cameron and Lakeview will be partially closed the weeks of September 2nd and September 8th. Alternating traffic will be allowed; flag-persons will be on site to manage the traffic

Storm sewer and water service connection work

  • Lakeview, from Cedar to Cameron,
  • Intersection of Cameron and Lakeview.

Street closures

The following street sections on Lakeview will be closed:

  • Cedar to Cameron (excavation for multi-use path infrastructure and drainage basin).
  • McNaughten to Cameron.

Intersection closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Cedar and Lakeview.
  • McNaughten and Lakeview.
  • Cameron and Lakeview.

Discoloured water

  • During the water service connection work, residents may notice temporary discolouration in their water. This is caused by the disturbance of naturally occurring iron particles that settle at the bottom of the aqueduct system.
  • As water flow is redirected during the connection process, these particles can become stirred up, leading to a change in water appearance. Despite the discolouration, the water remains safe to drink.
  • If you experience discoloured water, simply run your tap until it clears.
Work and closures planned: week of August 25, 2025

Storm sewer and water service connection work

  • Lakeview, Cedar to Cameron,
  • Lakeview, from McNaughten to Cameron.

Discoloured water

  • During the water service connection work, residents may notice temporary discolouration in their water. This is caused by the disturbance of naturally occurring iron particles that settle at the bottom of the aqueduct system.
  • As water flow is redirected during the connection process, these particles can become stirred up, leading to a change in water appearance. Despite the discolouration, the water remains safe to drink.
  • If you experience discoloured water, simply run your tap until it clears.

Street closures

The following street sections on Lakeview will be closed:

  • Cedar to Cameron
  • McNaughten to Cameron

Intersection closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Cedar and Lakeview.
  • Melrose and Lakeview.
  • McNaughten and Lakeview.
Work and closures planned: week of August 18, 2025

Storm sewer and water service connection work

  • Lakeview, from Pine to Cedar,
  • Lakeview, from McNaughten to Cameron,

Roadwork

  • Asphalt removal, from Cedar to Melrose,
  • Topsoil stripping, from Cedar to Melrose.

Other infrastructure work

  • Clearing and cutting roots using hydro-excavation.
  • Excavation for the multi-use path infrastructure and drainage basin.

Street closures

The following street sections on Lakeview will be closed to all but local traffic:

  • Selkirk to Pine
  • Pine to Cedar
  • Cedar to Melrose
  • McNaughten to Cameron

Intersection closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Cedar and Lakeview.
  • Pine and Lakeview.
  • Melrose and Lakeview.
  • McNaughten and Lakeview.
Work and closures planned: week of August 11, 2025

Storm sewer and water service connection work

  • Lakeview, from Pine to Cedar,
  • Lakeview, from McNaughten to Cameron,
  • McNaughten, from St-Jean to Lakeview.

Roadwork

  • Asphalt removal, from Cedar to Melrose,
  • Topsoil stripping, from Cedar to Melrose.

Other infrastructure work

Excavation for the multi-use path infrastructure and drainage basin.

Street closures

The following street sections on Lakeview will be closed to all but local traffic:

  • Selkirk to Pine
  • Pine to Cedar
  • McNaughten to Cameron

Intersection closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Cedar and Lakeview.
  • Pine and Lakeview.
  • McNaughten and Lakeview.
Work and closures planned: week of August 4, 2025
  • Removal, trimming and hydro-excavation of identified trees and vegetation from Selkirk to Oakland.
  • Storm sewer work and water connections from Selkirk to Pine.
  • Topsoil and asphalt removal between Pine and Cedar.
  • Storm sewer and water connection from Pine to Cedar.
  • Water main diversion and moving of the fire hydrant at the intersection of Maple and Lakeview (water may be shut off for a short period of time).
  • Storm sewer and water connection from McNaughten to Cameron.
    Storm sewer (overflow) installation on McNaughten Street.

Boil-Water Advisory
Residents living along Lakeview between Hazelwood and Maple streets should anticipate receiving a hand-delivered preventive boil-water advisory once the fire hydrant has been relocated. Expect the advisory to last approximately 72 hours. A hand-delivered notice will be distributed as soon as the advisory is lifted.

Closures

The following intersections may be fully or partially closed. Please respect the signage in place:

  • Cedar and Lakeview.
  • Pine and Lakeview.
  • Selkirk and Lakeview.
  • Maple and Lakeview.
  • McNaughten and St-Jean.
Lakeview Street Update, week of July 14, 2025

The Reconstruction Phase begins in Zone 1

The majority of vegetation designated for removal between Selkirk and McNaughten has been cleared.
A site inspection to identify and mark trees and vegetation for removal along Lakeview’s western section, from Selkirk to Oakland, is scheduled for the week of July 21.
A reminder that the Lakeview project has been divided into two zones, with Selkirk as the lowest drainage point:
• Zone 1: to the east, from Selkirk to McNaughten; and
• Zone 2: to the west, Selkirk to Oakland.

Planned Work Starting Monday, July 14 (Zone 1: Selkirk to McNaughten)
1. Ongoing extension of the sewer network at the intersections of Selkirk, Pine, Cedar and Melrose;
2. Removal of the asphalt between Selkirk and Pine; and
3. Relocation of the fire hydrant at the corner of Pine and Lakeview.

Boil-Water Advisory: Residents living in the area of Pine and Lakeview should anticipate receiving a hand-delivered preventive boil-water advisory once the fire hydrant has been relocated. Expect the advisory to last approximately 72 hours. A hand-delivered notice will be distributed as soon as the advisory is lifted.

Closures
Fully Closed Intersection: Selkirk & Lakeview
Partially Closed Intersections (south side):

  • Pine & Lakeview
  • Cedar & Lakeview
  • Melrose & Lakeview

Collections
Garbage, recycling, compost, and bulky items will be collected between 5 a.m. and 7 a.m. in the area bordered by Main Road, Oakland, and Cameron on the regular collection day for the duration of the project, scheduled to end on October 31, 2025.
Please place your bins at the end of your driveway the night before.

Lakeview Street Update, week of July 7, 2025

Removal of vegetation in Zone 1 (Selkirk to McNaughten) to begin

On July 2nd, the Town’s Environment Technician along with the Landscape Architect, and Civil Engineers hired for the project, conducted a site inspection along the eastern portion of Lakeview from Selkirk to McNaughten. The objective of this inspection was to identify and mark the vegetation and trees for removal. During this inspection five (5) trees previously slated for removal were identified as being possible to conserve using specialized excavation methods with hydro-excavation rather than traditional mechanical equipment. These trees include two (2) Norway Maples, one (1) Silver Maple, one (1) Oak, and one (1) Fir.

The inspection along the western portion of the Lakeview project, from Selkirk to Oakland is planned to take place in the coming weeks.

The Lakeview project has been divided into two zones of Selkirk as the lowest drainage point:

Zone 1: to the east, from Selkirk to McNaughten

Zone 2: to the west, Selkirk to Oakland

The Construction preparation phase will continue during the week of July 7, 2025 in Zone 1 (Selkirk to McNaughten) and includes the following activities:

1. Removal and trimming of identified trees and vegetation:

a. Trees marked with a red dot will have their branches trimmed to prevent damage during construction. This work will be performed by a certified arborist;

b. Trees marked with a red “TH” will be removed;

c. Hedges, partial hedges, smaller trees, and other vegetation located within the public right of way will also be removed.

2. Exploratory excavation for grading;

3. Extension of the sanitary sewer network at the intersections of Selkirk, Pine, Cedar and Melrose streets;

4. Installation of worksite signage; and

5. Mobilization of equipment and materials.

Additionally, a temporary watermain will be installed on the south side of Lakeview between Maple and Melrose streets. This will serve as an emergency water source should water service need to be interrupted during construction. Please note that throughout the construction phase, water will be available in the mornings, evenings, and overnight. Any planned daytime water shutdowns will be communicated in advance to allow sufficient preparation time.

Lakeview Street Update, week of June 30, 2025

Identification of vegetation to be removed begins on July 2

The final preparations prior to the excavation phase continue during the week of June 30th and include:

Description Start Date
Camera inspections:

Video recordings will be made of properties and three sides of each building along Lakeview. This documentation serves as a “before” record prior to excavation and helps protect property owners in the event that construction work causes any damage.

On-going
Exploratory excavation for grading June 30
Identification and marking of the vegetation to be removed

Our Environment Technician, Landscape Architect, and a representative from Shellex will be walking the site to identify all vegetation and trees slated for removal.

July 2

All work will be carried out on weekdays between 7:00 a.m. and 6:00 p.m.

The excavation phase is scheduled to begin on July 14.

The project

Due to its advanced state of deterioration, Lakeview Street must be completely rebuilt. We are also required to upgrade the drainage system to meet current environmental standards.

To enhance pedestrian safety, a *multi-use path will be added on the north side (river side). This path will be 2.5 metres wide (1 metre narrower than a bike path), with a 1-metre planting/drainage strip separating it from the street.

The path will extend to Oakland and to McNaughten and connect to existing paths that lead to Westwood Senior and St. Thomas schools.

The total width of Lakeview (including the path) will be increased from 6.5m to 11m (21.5 to 36 feet).

Speedbumps will be installed at all intersections that do not have stop signs.

Sump pump pipes for properties along the south side of Lakeview will be connected to the new drainage system, removing the need for ditches.

Benches and trash cans will be installed in 6 locations along the new path.

Investment and financing

Total investment:  $4 million

Investment to date: $803,475

  • Plans, geotechnical study and preparatory work: $122 575
  • Rebuilding of Selkirk below Lakeview, updating drainage system, installation of sidewalk and planted strip: $680 900

To reduce the financial burden on taxpayers, 50% of the cost of this project will be financed by a $2.04 million Federal Government grant.

The path itself, which is a condition of the grant, is expected to cost approximately $250K.

Impact

To make room for the multi-use path, the Town will use the Town right-of-way (property owned by the Town outside of the property lines). This means:

In some cases, vegetation or structures located in the municipal right-of-way (outside of the property lines) will be removed.

Trees that are dead, dying, or that will become hazardous due to excavation work required for the project will be removed. To offset this, at least two new trees will be planted for every tree that is cut. In addition, five high-value trees have been identified for conservation and will be protected throughout the project.

Individual meetings with property owners affected by the project have begun to explain the impacts and to propose solutions to replace what will be removed.

Mature plants and trees will be used as replacement plantings. A landscape architect will also be hired to review the existing plans and to suggest improvements.

What is a multi-use path?

It is a designated pathway intended to safely accommodate multiple types of non-motorized users. This typically includes:

  • Pedestrians (walkers, joggers)
  • People using wheelchairs or other mobility devices
  • Baby carriages
  • Bicycles and scooters

Project timeline

2021

  • Beginning of the project study process.
  • July: Contract awarded to Shellex Groupe Conseil inc. for plans and specifications.
  • December: Geotechnical study completed.

2022

  • January: The federal government announces a new grant for active transportation (ATF).
  • November: Grant application approved.
  • November: The MELCC confirms to Shellex that the entire project is subject to a ministerial authorization (CA) and that drainage on Selkirk Street must be modified to manage the flow.

2023

  • January: CA application submitted to the MELCC.
  • June: Contract awarded for work on Selkirk Street. The Selkirk Street project is postponed to 2024 due to delays in the ATF grant caused by the governments of Quebec and Canada.

2024

  • June: Grant approved by the MAMH and the federal government.
  • June: The contractor for Selkirk Street receives approval to begin work.
  • October: Ministerial authorization (CA) received for Lakeview Street.
